If you live in the Fauntleroy-area neighborhood where Seattle City Light is working on long-needed underground repairs and updates, Brace Point, you’ve probably closely followed their progress. For those who haven’t, here’s the latest of SCL’s periodic updates:
Seattle City Light contractors continue to work on the underground electrical infrastructure serving the Brace Point neighborhood. They are installing new duct banks, conduits, cables, vaults, and streetlights. The new infrastructure will help reduce the risk of outages and improve service for residents.
Underground civil construction is approximately 32% complete. Our crews have installed 3,470 linear feet of conduit and 13 underground electrical vaults. We expect to finish most civil construction by the end of 2026. After that, crews will focus on cleaning staging areas and restoring the project area to the same, if not better, condition.
You can reach our team at bracepointcable@stephersonassociates.com or 206-312-0021.
If you would like to talk to a member of the project team in person, you can find us in the upstairs meeting room at the Southwest Branch of the Seattle Public Library on Wednesday, April 8 from 12-1 PM.

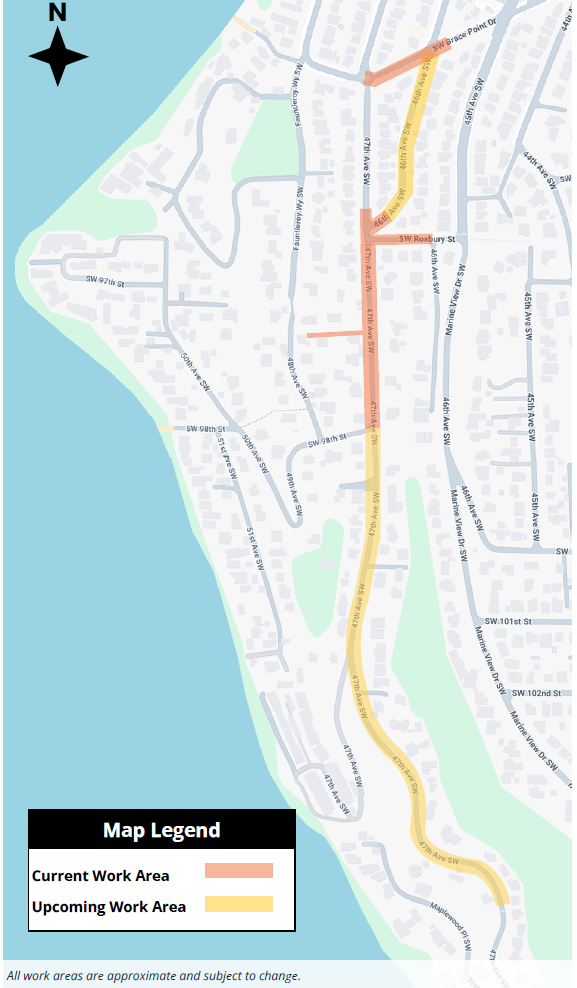

Current work areas:
Southwest Brace Point Drive: Crews are working near the intersection of 46th Ave. SW and SW Brace Point Drive.
47th Ave. Southwest: Crews are working north along 47th Ave. SW near the intersection of 46th Ave. SW and SW Roxbury St. Please drive carefully through this intersection and expect changing traffic patterns as the work progresses.
Longer than usual delays: Concrete pours are scheduled to occur on Wednesdays from 8 AM – 2 PM for the remainder of the project. Due to the narrow streets, trucks may have to park in the right-of-way. Please plan for longer than normal delays during these times.
Pedestrian trail: Crews are running new conduit and replacing the streetlight on the trail between 47th Ave.
Southwest to 48th Ave. Southwest. The trail is closed and expected to reopen in mid-April, once crews have finished the foundation for the new light pole. They will restore any areas disturbed by the project to City standards.Upcoming work areas
46th Ave. Southwest: After crews complete work on Brace Point Drive, they will start utility work on the segment of 46th Ave SW between Brace Point Drive and the intersection of SW Roxbury St and 47th Ave SW.
47th Ave. Southwest: This spring, crews will start working near the south end of 47th Ave. SW and work north towards the intersection of SW 98th St.
The work finally started last fall, five years after the originally projected start date.
